How utilities can ensure grid readiness: A holistic framework from NEOS Advisory

How utilities can ensure grid readiness: A holistic framework from NEOS Advisory

22 May 2026 Consultancy-me.com
How utilities can ensure grid readiness: A holistic framework from NEOS Advisory

Facing major trends such as electrification, renewables, technological advancement, and climate, utility companies are being forced to rethink how they operate, manage, and invest in their electricity grids. Experts from NEOS Advisory provide a long-read on how that strategic journey could be shaped, offering a holistic framework for designing the grid of the future.

Electric utilities are entering a period in which traditional network planning is no longer sufficient. For decades, most utilities planned around relatively stable load growth, centralized generation, predictable peak demand patterns, and largely passive customers.

That model is being disrupted by five simultaneous forces: accelerating electrification, rapid renewable energy deployment, the proliferation of distributed energy resources (DERs), the emergence of large and fast-growing new loads such as data centers and green hydrogen facilities, and rising exposure to climate, cyber, and operational resilience risks. The result is not simply a need for more grid capacity. It is a need for smarter, faster, and more adaptive utility planning.

The scale of this challenge is big. The IEA forecasts global electricity demand to grow at an average annual rate of 3.6% between 2026 and 2030 – approximately 50% higher than the average of the previous decade. Data center electricity consumption alone is projected to nearly double to around 945 TWh by 2030, growing at roughly 15% per year.

These trends translate directly into local distribution constraints, transmission bottlenecks, resource adequacy risks, connection backlogs, voltage instability, transformer overloads, and growing pressure on capital budgets.

At the same time, the grid has become the central bottleneck of the energy transition. The IEA estimates that at least 3,000 GW of renewable power projects – including 1,500 GW in advanced stages – are waiting in grid connection queues globally. New grid infrastructure takes 5 to 15 years to plan, permit, and build, compared with 1 to 5 years for wind and solar, 1 to 3 years for data centers, and 1 to 2 years for EV charging infrastructure.

This fundamental mismatch means utilities can no longer treat network planning as a periodic engineering exercise. It must become a continuous, data-driven, scenario-based capability at the heart of utility strategy.

To help leaders through the transition to a future-proof grid, NEOS Advisory has developed an integrated framework for utility readiness – one that connects resource adequacy planning, hosting capacity studies, network master planning, digitalization, and investment planning into a coherent strategic capability. The framework draws on market redesigns and regulatory reforms from around the world, to ensure the framework is globally relevant.

The Convergence Problem: Fragmented Planning in an Integrated System

Modern utilities face a convergence of risks that have historically been managed in separate organizational silos. Resource adequacy teams assess generation capacity margins. Network planners size transmission and distribution reinforcements. DER teams manage connection applications. Digital teams deploy technology platforms. Finance teams prioritize capital expenditure. Regulatory teams manage tariff filings and investment approvals. Customer teams respond to increasingly impatient connection applicants, developers, large-load customers, and prosumers.

The critical insight – and the central problem – is that these workstreams are deeply, inextricably interdependent. A resource adequacy shortfall may originate in insufficient firm capacity, but it can equally be worsened by transmission congestion, an absence of demand response, poor visibility of distributed resources, or delayed interconnection of batteries and renewables.

A distribution hosting capacity constraint may not require conventional reinforcement if flexible demand management, dynamic operating envelopes, smart inverters, or targeted automation can unlock latent capacity.

A capital investment plan may appear optimal in narrow engineering terms while failing commercially because it does not account for climate resilience, customer connection timelines, land availability, supply chain constraints, regulatory cost recovery, or operational readiness.

This is why utilities must move from asset-by-asset planning to system readiness planning. The central planning question can no longer be merely: “What assets do we need to build?”

It must be: “What combination of resources, networks, digital capabilities, flexibility mechanisms, operational tools, and capital investments will allow this utility to meet demand securely, connect customers efficiently, integrate clean energy at scale, manage deep uncertainty, and remain resilient under stress?”

The Organizational Trap
Many utilities have attempted to address planning fragmentation by creating cross-functional committees or strategic planning teams. These initiatives rarely succeed if the underlying data, models, and planning assumptions remain siloed by department.

Genuine integration requires a shared spatial dataset, common scenario assumptions, a unified planning model that links adequacy, network capacity, and investment, and governance structures that make cross-functional planning accountable.

Utilities that invest in this integration – in data governance, shared modeling environments, and cross-disciplinary planning teams – consistently outperform peers on connection speed, investment efficiency, and regulatory outcomes.

Electricity grids are coming under pressure due to the rise of renewables and assets nearing the end of their lifecycle

Electricity grids are coming under pressure due to the rise of renewables and assets nearing the end of their lifecycle

1) Resource Adequacy

Resource adequacy planning has historically focused on whether a system has sufficient installed or dependable capacity to meet peak demand plus a reserve margin. This remains a necessary condition, but it is no longer a sufficient one. As power systems add variable renewables, battery storage, demand response, and weather-sensitive loads, adequacy must be assessed across all hours, all seasons, and under a far wider range of stress scenarios than traditional peak-day analysis supports.

North American Electric Reliability Corporation’s (NERC) 2024 Long-Term Reliability Assessment makes this shift explicit. It emphasizes the need to incorporate energy risk and extreme weather scenarios into resource and system planning, and to conduct all-hours probabilistic analyses for evaluating resource adequacy. It notes that demand forecasts are outpacing resource additions in several US regions, leading to falling reserve margins and emerging shortfall risks during extended heat events and renewable drought conditions.

The adequacy problem is increasingly about whether resources can produce or reduce demand when and where they are needed, not merely whether sufficient nameplate capacity exists on paper.

Four Dimensions of Modern Adequacy
For modern utilities, resource adequacy planning should be structured around four interconnected dimensions:

  • Capacity adequacy: whether firm resources can reliably meet peak demand, accounting for planned and forced outages and the dependable contribution of variable and storage resources.
  • Energy adequacy: whether the system can meet demand across extended multi-day or multi-week periods, including low-renewable-output events, fuel supply constraints, drought affecting hydro generation, or prolonged heat waves.
  • Flexibility adequacy: whether sufficient ramping capability, fast-response reserves, inertia, voltage support, and frequency regulation services exist to manage net-load variability and maintain system stability.
  • Deliverability adequacy: whether generation, imports, storage, and demand-side resources can physically reach load centers through the transmission and distribution network – a constraint that pure capacity analysis routinely ignores.

NERC’s assessment of ERCOT illustrates the urgency of this broader lens: forecast summer peak demand is projected to rise from 94,650 MW in 2026 to over 154,000 MW in 2035, driven substantially by data center load interconnections. This illustrates a wider reality: utilities must now evaluate not only how much new demand may materialize, but also how firm that demand is, where it will connect, whether it carries controllable load provisions, what grid upgrades it triggers, and whether large customers should be required to contribute flexibility services as a condition of connection.

Demand Response and Flexibility as Adequacy Resources
A consequential evolution in adequacy planning is the recognition of demand-side resources as structural contributors to system reliability, not merely emergency backstops. Virtual power plants (VPPs) – aggregations of distributed batteries, EV chargers, smart thermostats, and industrial flexible loads – are increasingly being procured through capacity markets and reliability contracts.

The IEA estimates that demand response and smart charging could contribute flexibility equivalent to hundreds of gigawatts of firm capacity globally by 2030.

For utilities conducting adequacy assessments, this means DER aggregations must be modeled with appropriate dependability factors, dispatch constraints, and customer participation assumptions. An adequacy study that treats demand response as zero or that excludes distributed storage fundamentally misprices the cost of meeting reliability standards – and risks both underbuilding and overbuilding conventional resources.

Regional Dimension: US Interconnection Reform
FERC Order 2023 (2023) mandates a comprehensive reform of the generator interconnection process, moving from a serial, first-come-first-served queue to a cluster study approach. For resource adequacy planners, this is significant: the timing and certainty of new resource interconnections will change materially.

Utilities and regional transmission organizations must update their adequacy assessments to reflect both the new interconnection timeline expectations and the risk of project attrition – historically, 70% to 80% of queued projects in the US do not reach commercial operation.

2) Hosting Capacity

The distribution network is no longer passive. Rooftop solar, batteries, EV chargers, heat pumps, small-scale wind, and flexible commercial loads are changing power flows at the feeder, transformer, and service-connection level. Without systematic hosting capacity analysis, utilities are forced into reactive, case-by-case interconnection studies, slow application processing, conservative and often opaque connection limits, and costly ad hoc upgrades that arrive too late for customers who have already invested.

NREL defines hosting capacity as the maximum amount of distributed generation that can be accommodated on a feeder or substation without requiring infrastructure upgrades or causing power quality, protection, or operational violations. A mature hosting capacity program covers steady-state power flow analysis, dynamic simulation, voltage rise and flicker assessment, harmonic analysis, fault level and protection coordination studies, and transformer thermal loading.

Crucially, it must be maintained as a living model – updated as new connections are made, network conditions change, and operating practice evolves.

EV chargers are changing power flows at the feeder, transformer, and service-connection level

EV chargers are changing power flows at the feeder, transformer, and service-connection level

Static Hosting Capacity versus Dynamic Operating Envelopes
The most significant evolution in this space is the shift from static hosting capacity to dynamic operating envelopes (DOEs). Static hosting capacity assigns a fixed export or import limit to each connection point based on worst-case network assumptions. Dynamic operating envelopes, by contrast, provide real-time or day-ahead limits that reflect actual network conditions – meaning a solar installation can export more on a cool, lightly loaded morning than on a hot summer afternoon when the feeder is constrained.

Australian Renewable Energy Agency’s (ARENA) research in Australia has demonstrated that DOEs can increase the hosting capacity of constrained feeders by 30% to 60% without physical reinforcement, by allowing the network operator to differentiate limits across customers, times, and conditions.

California’s Rule 21 and IEEE 2030.11 provide the interconnection framework within which DOE implementations are evolving in the US context. For utilities in growth markets – where the connection queue is expanding faster than reinforcement programs can respond – DOEs represent one of the highest-value investments available.

Hosting Capacity as a Planning and Market Signal
A mature hosting capacity program serves multiple strategic purposes beyond technical compliance. Used proactively, it becomes a planning, investment, customer service, and market-enabling tool. Published hosting capacity maps can guide developers toward less constrained, lower-cost connection locations. Integration with interconnection application processing can automate screening and eliminate manual study bottlenecks for small and medium DERs.

Connection of the hosting capacity model to the investment planning process allows the utility to identify and prioritize targeted reinforcements that unlock the greatest capacity for the least capital outlay.

The US Department of Energy’s DER Interconnection Roadmap identifies the need for utilities to move from case-by-case interconnection to scalable, transparent, and data-driven processes – particularly for the growing volume of hybrid facilities (solar plus storage), EV charging infrastructure, and large industrial customers seeking flexible connection agreements. Hosting capacity analysis is foundational to this transition.

Implementation Failure Mode
The most common failure in hosting capacity programs is treating the analysis as a one-time or annual study rather than a continuously maintained operational data asset. Network topology changes, new connections, seasonal load variations, and protection setting updates all affect hosting capacity – sometimes significantly. A hosting capacity map that is 12 months out of date can be worse than no map at all, because it creates false confidence in connection teams and misleads developers.

Best practice: hosting capacity models should be updated dynamically (or at a minimum, quarterly) and linked directly to the interconnection application management system.

3) Network Master Planning

Network master planning provides the long-term physical and operational architecture of the grid. In the modern context, a master plan must not be a static inventory of substations, lines, transformers, and feeders scheduled for replacement or expansion. It must be a scenario-based strategic roadmap that links demand growth trajectories, generation development, distributed resource penetration, resilience requirements, operational technology evolution, digital system requirements, land-use planning, and capital sequencing.

What a Modern Master Plan Must Include
A robust network master plan should integrate transmission, sub-transmission, and distribution planning into a single coherent architecture. It should explicitly map load growth zones (urban densification, industrial clusters, data center corridors), renewable energy development zones, EV charging infrastructure corridors, water-energy interdependencies, and climate-exposed assets. It should define where the network is heading across at least three plausible futures, not a single central forecast.

Three categories of investment should be distinguished within the master plan:

  • Capacity investment: new substations, feeders, lines, transformers, and grid interconnections required to serve load growth and enable new generation connections.
  • Operational investment: automation, advanced voltage control, protection modernization, control room technology, outage management systems, and communications infrastructure required to operate the network reliably and efficiently.
  • Resilience investment: redundancy architecture, selective undergrounding, flood and wildfire mitigation, mobile substations, black-start capability, feeder sectionalization, microgrids for critical facilities, and cybersecure operational technology design.

Scenario Planning and Stress Testing
A master plan that is built around a single demand forecast is not a plan – it is an assumption. Modern master planning requires explicit scenario analysis: high electrification versus moderate, rapid data center growth versus deferred, accelerated rooftop solar versus policy-constrained, extreme heat versus normal weather, delayed generation interconnection versus on-schedule. Each scenario will identify different constraint points, different investment priorities, and different sequencing logic.

The value of scenario planning is not to predict which future will occur. It is to identify which investments are robust across multiple futures (candidates for near-term commitment) and which should be staged, deferred, or kept as real options until uncertainty resolves. This distinction between no-regrets investments and optionality investments is the analytical core of a modern master plan.

Grid-Enhancing Technologies: An Underutilized Tool
A dimension frequently missing from network master plans is the systematic evaluation of grid-enhancing technologies (GETs) – a category that includes advanced power flow controllers, dynamic line ratings (DLR), topology optimization software, high-temperature low-sag (HTLS) conductors, and advanced reconductoring with composite cables.

The US Department of Energy’s Transmission Needs Study and EPRI research indicate that GETs can increase effective transmission and distribution capacity by 20% to 40% on targeted circuits without building new infrastructure. In congested interconnection queues, this is transformative: a constrained 230 kV line equipped with DLR and power flow control may be able to accommodate two to three times the renewable energy connections previously assessed as infeasible.

GETs should be evaluated systematically in every master planning cycle as a complement to – and in many cases a substitute for – conventional build solutions.

Utilities in the Middle East face a distinct planning environment

Utilities in the Middle East face a distinct planning environment

Regional Dimension: The Middle East Context
Utilities in the Gulf Cooperation Council face a distinct planning environment: extreme cooling demand with high peak-to-average load ratios, rapid urban development and large-load growth (data centers, green hydrogen, desalination), historically low distributed generation but accelerating rooftop solar programs, and ambitious decarbonization targets (UAE Net Zero 2050, Saudi Vision 2030, Qatar National Vision).

For DEWA, TAQA, SE, NAMA and regional peers, network master planning must address: the integration of utility-scale solar and storage at unprecedented scale; smart grid rollouts requiring significant AMI, SCADA, and ADMS investment; the technical integration of bidirectional flows on networks designed for unidirectional supply; and workforce localization requirements for network planning and operations roles.

The leapfrog opportunity is real: utilities in the region can adopt digital-first, DOE-enabled interconnection processes and scenario-based planning frameworks without the legacy system constraints faced by many European and North American counterparts.

4) Network Digitalization

Digitalization is the capability that transforms physical grid assets into an observable, controllable, and optimizable system. Without it, utilities cannot accurately model distributed resources, forecast feeder-level demand, identify outages rapidly, manage voltage dynamically, process DER interconnections efficiently, or use flexibility as an alternative to reinforcement.

The IEA states that clean energy transitions require a fundamental transformation of power systems, including substantially higher levels of digitalization across generation, transmission, distribution, and end-use sectors.

The economic case for digitalization is compelling. The IEA has estimated that digital technologies could save up to $1.8 trillion of grid investment globally through 2050 by extending asset lifetimes, integrating renewables more efficiently, and minimizing supply interruptions. IRENA’s work on digitalization and energy transition similarly documents value creation across forecasting, operations, maintenance, customer engagement, and market participation.

The question for utilities is not whether to invest in digitalization, but how to sequence it effectively, integrate it with operational practice, and govern the data it generates.

The Digital Architecture Stack
For utilities, digitalization should be planned as an integrated architecture, not as a portfolio of isolated technology procurements. The core layers of this architecture, from the field to the enterprise, are:

  • GIS (Geographic Information System): the spatial asset record - the foundation for network modeling, field operations, hosting capacity analysis, and investment planning. Data quality here is a prerequisite for everything above it.
  • AMI (Advanced Metering Infrastructure): the customer and low-voltage data layer - enabling time-of-use tariffs, outage detection, transformer loading intelligence, customer demand analysis, and distributed storage monitoring.
  • SCADA: real-time supervisory control and data acquisition across transmission and distribution substations.
  • ADMS (Advanced Distribution Management System): the distribution operations platform - enabling advanced switching, fault location, isolation and service restoration (FLISR), volt/VAR optimization, and real-time situational awareness.
  • OMS (Outage Management System): integrated outage response, crew dispatch, and customer communication.
  • DERMS (Distributed Energy Resource Management System): the DER orchestration layer - monitoring and dispatching distributed solar, batteries, EV charging, and flexible demand.
  • Digital twins: virtual network replicas enabling scenario simulation, asset risk modeling, and investment planning without operational disruption.
  • AI and advanced analytics: improving load forecasting, predictive maintenance, storm response, renewable output forecasting, and DER dispatch optimization.

The Data Governance Problem
The most common reason utility digitalization programs fail to deliver their expected value is not technology – it is data. Most utilities operate in fragmented digital landscapes: GIS data that does not reflect as-built network conditions, AMI data that is not integrated with network models, SCADA tags that are inconsistently named across substations, and OMS tickets that contain insufficient location precision to support analytics.

Deploying an ADMS or DERMS on top of poor data produces unreliable results, erodes operator confidence, and ultimately results in under-utilization of expensive platforms.

A modern utility digitalization roadmap must begin with a rigorous data quality program: asset model validation, GIS field verification, connectivity model cleansing, meter data reconciliation, and integration architecture design. This is foundational infrastructure, not a preparatory step that can be skipped in favor of faster platform deployment.

Cybersecurity: The Non-Negotiable Dimension
The convergence of operational technology (OT) and information technology (IT) that characterizes modern grid digitalization is simultaneously the sector’s greatest capability expansion and its most significant increase in attack surface. SCADA systems, ADMS platforms, smart meters, EV chargers, and building energy management systems are all becoming networked, software-driven, and remotely accessible. Each connection point is a potential entry vector for a threat actor capable of disrupting electricity supply at scale.

Utilities must embed cybersecurity architecture into digitalization programs from the outset – not as a bolt-on compliance requirement. This means: network segmentation between OT and IT environments, zero-trust access controls for remote operations, encryption of all communications to and from field devices, intrusion detection monitoring of SCADA and ADMS systems, incident response planning that includes grid restoration scenarios, and regular penetration testing of critical systems.

Adherence to IEC 62351 (power systems communications security) and NERC CIP (critical infrastructure protection) standards provides a baseline, but the evolving threat landscape requires continuous review.

The Workforce Dimension
Digital systems in utilities are frequently deployed but underutilized because planning engineers, control room operators, protection engineers, and field crews are not trained, empowered, or motivated to use new capabilities. An ADMS with 40% of its functionality in active use – the industry average in many regions – is a significant waste of capital investment and a missed operational opportunity.

Utilities that successfully extract value from digital investment treat workforce transformation as integral to the program, not as a training annex. This means: co-designing operating procedures with the people who will use the systems, embedding digital tools into performance management and decision-making processes, developing specialist digital roles (data scientists, OT cybersecurity engineers, DER analytics specialists) alongside traditional network engineering roles, and partnering with universities and technical colleges to build the pipeline of digitally capable engineers the sector will require.

AI in Grid Operations: Beyond the Hype
The rapidly emerging technology artificial intelligence is generating significant interest in utility boardrooms, but practical application requires clarity about where AI creates genuine value and where it creates noise.

Proven high-value applications include: feeder-level short-term load forecasting (reducing forecast error by 15% to 30% versus statistical models), transformer health scoring and predictive maintenance scheduling, storm outage prediction and pre-positioning of repair crews, renewable output forecasting for dispatch and adequacy assessment, and DER settlement and fraud detection in AMI data.

Applications requiring more maturity before deployment at scale include: fully autonomous grid switching, AI-driven tariff design, and unsupervised DER dispatch optimization. For these, human oversight and explainability requirements remain high.

Utility investment planning must balance a demanding set of simultaneous objectives

Utility investment planning must balance a demanding set of simultaneous objectives

5) Investment Planning

Investment planning is where the technical roadmap becomes a funded, sequenced, and accountable delivery program. Modern utility investment planning must balance a demanding set of simultaneous objectives: expanding network capacity, replacing ageing assets, connecting renewable generation, modernising digital systems, improving resilience, enabling customer flexibility, and maintaining tariff affordability.

Achieving this balance requires a more sophisticated approach than traditional asset management or engineering-driven capital planning.

The Regulatory Economics Dimension
A dimension frequently overlooked in technical investment planning is the structural tension created by rate-of-return regulation. Traditional regulatory frameworks incentivize capital expenditure – utilities earn a return on rate base, which grows with asset investment. This creates a misalignment with the objective of least-cost, customer-centric planning, where the optimal solution increasingly involves non-wires alternatives (demand response, storage, flexibility contracts, dynamic tariffs) and operational improvements that do not generate the same regulated return.

This structural tension is being addressed in several regulatory jurisdictions. Ofgem’s RIIO framework in the United Kingdom explicitly funds outputs – reliability, connections, customer satisfaction, carbon reduction – rather than just inputs, creating incentives for network operators to use the most efficient combination of wires and non-wires solutions.

Performance-based regulation (PBR) models in several US states (New York, California, Hawaii) are similarly evolving to reward efficiency and innovation rather than pure capital deployment. Utilities operating in MENA concession frameworks face different but related challenges: concession agreements that define outputs but leave planning methodologies to the concessionaire create both flexibility and risk.

For utility investment planners, understanding the regulatory model – and actively engaging with regulators to modernize incentive structures – is as important as understanding the engineering requirements. An investment portfolio that is technically optimal but not recoverable under the prevailing regulatory compact is not a plan; it is a wish list.

Portfolio Optimization Under Uncertainty
A better approach to investment planning is to treat it as portfolio optimization under uncertainty. Each investment should be assessed against multiple value streams: avoided outages, reduced losses, improved hosting capacity, faster customer connections, deferred reinforcement, improved safety, reduced emissions, increased resilience, lower operating costs, and improved customer experience.

This multi-criteria assessment is particularly important when comparing conventional wire solutions with non-wire alternatives, and when decisions must be made under scenarios with materially different outcomes.

The portfolio should be structured in two layers:

  • No-regrets investments: needed under virtually all plausible scenarios - critical asset replacement, safety-critical upgrades, protection modernization, data quality improvement, control-center modernization, and reinforcement of already overloaded assets. These should be committed and sequenced without delay.
  • Optionality investments: staged commitments that preserve flexibility as uncertainty resolves - land acquisition for future substations, modular substation designs, scalable communications networks, phased AMI deployment, flexible interconnection schemes, and non-wires alternative pilots. These should be structured as real options, with defined trigger points for commitment.

Research by The Brattle Group demonstrates that proactive, scenario-driven grid investment – investing ahead of constraint emergence rather than reactively – consistently produces better outcomes for customers and utilities. Reactive investment carries hidden costs: emergency procurement premiums, customer compensation costs, reputational damage, regulatory scrutiny, and lost renewable connection opportunities.

The IEA estimates that meeting global electricity demand through 2030 will require annual grid investment to increase by approximately 50% above 2024 levels, making capital allocation discipline, not just capital availability, the binding constraint.

Long-Duration Energy Storage in Investment Portfolios
Long-duration energy storage (LDES) – including iron-air batteries, vanadium flow batteries, compressed air energy storage, and green hydrogen with reconversion – is an emerging but increasingly important component of utility investment portfolios. The IEA’s analysis identifies LDES as critical to energy adequacy in high-renewable systems: where lithium-ion storage addresses intra-day flexibility, LDES addresses multi-day and seasonal adequacy gaps that would otherwise require firm peaking capacity or cross-border imports.

For investment planners, this means LDES should now feature in resource adequacy modeling, master planning scenarios, and procurement strategies – particularly for utilities with high renewable penetration targets and limited interconnection to neighboring systems.

The Workforce and Supply Chain Constraint
No investment portfolio is credible if it cannot be delivered. The electricity sector faces an acute and growing constraint in both skilled workforce and supply chain capacity. Grid engineers, protection specialists, power systems planners, high-voltage cable installers, transformer manufacturers, and OT cybersecurity professionals are all in short supply globally.

Lead times for large power transformers have extended from 12-18 months to 3-5 years in some markets. Conductor and cable supply chains are strained by the simultaneous demands of offshore wind, onshore grid expansion, and EV charging infrastructure.

Investment planners must build workforce capacity and supply chain commitments into their program plans alongside technical and financial analysis. A capital program that is funded and technically justified but cannot be built on schedule – because engineers are not available or transformer orders are queued for four years – delivers no reliability benefit and may incur high regulatory and reputational costs.

Regional Dimension: European Market Reform
The EU Electricity Market Reform (Regulation 2024/1747) introduces significant changes to long-term electricity market design, including two-way contracts for difference (CfDs) for new low-carbon generation, enhanced demand response frameworks, and distribution system operator (DSO) flexibility procurement obligations.

For European network planners, the DSO flexibility obligation is particularly consequential: networks must now actively procure demand-side flexibility and storage before authorizing conventional reinforcement, and must demonstrate they have assessed non-wires alternatives in investment justifications. This makes hosting capacity analysis, DER modeling, and flexibility market design integral to the network planning regulatory submission process – not optional enhancements.

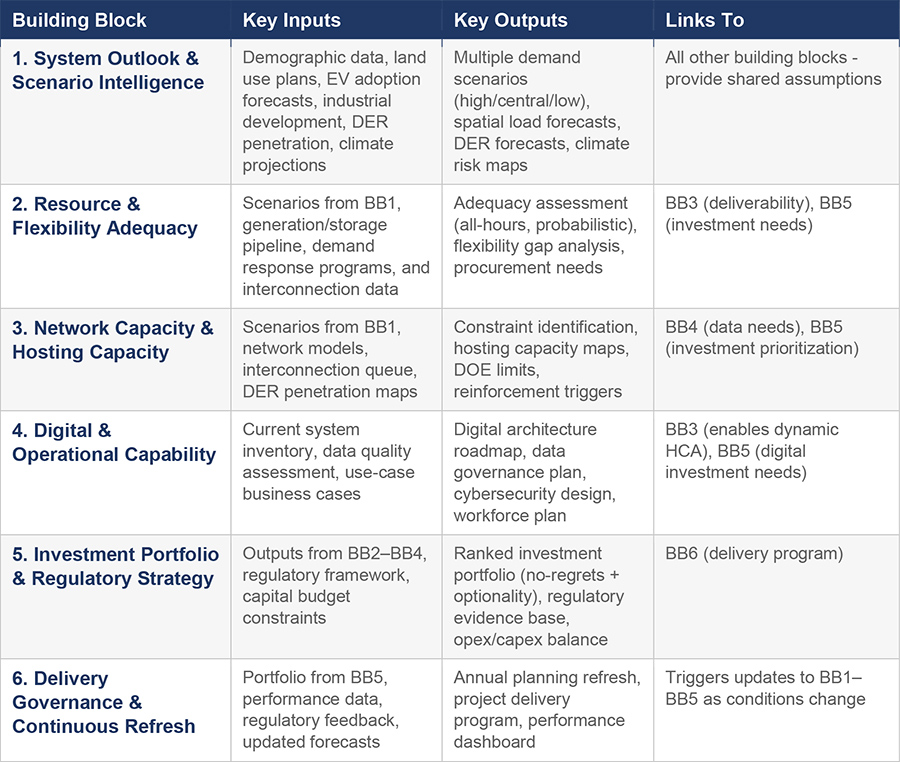

An Integrated Utility Readiness Framework

The five disciplines examined are not independent workstreams that happen to touch each other at the margins. They are interdependent components of a single strategic capability: utility readiness. The integrated framework from NEOS Advisory organizes this capability around six building blocks, each with defined inputs, outputs, and connections to the others.

How utilities can ensure grid readiness: A holistic framework from NEOS Advisory

The framework is designed to be iterative, not linear. Building Block 6 – delivery governance and continuous refresh – feeds back into Building Block 1 each year, incorporating updated demand actuals, new climate data, regulatory developments, and technology cost changes. The objective is not a five-year planning cycle that produces a document. It is a living planning capability that is continuously calibrated to reality.

What Integration Looks Like in Practice
A utility operating this framework does not conduct separate resource adequacy studies, hosting capacity studies, and master planning exercises. It maintains a common spatial dataset, a shared scenario set, and an integrated planning model that produces outputs across all five disciplines simultaneously.

When a new large-load customer applies for connection, the integrated model immediately identifies: which substation and feeder will serve it, what the adequacy impact is at the system level, whether hosting capacity exists or a substation upgrade is needed, what the investment cost and timeline are, whether flexibility procurement could defer part of the reinforcement, and what regulatory evidence is needed to support cost recovery.

This is not aspirational – utilities in Australia, the UK, and the Netherlands are operating at or near this level of integration today. The capability gap between leading and lagging utilities is widening.

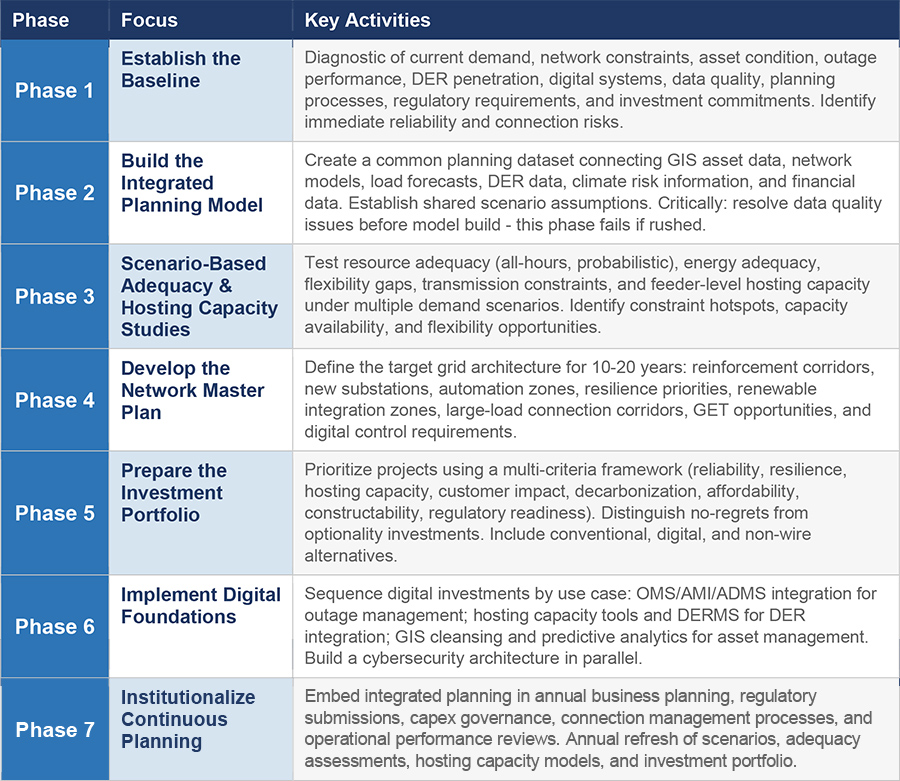

A Practical Implementation Roadmap

Implementing an integrated utility readiness capability is a multi-year organisational and technical programme. A seven-phase roadmap provides a sequenced approach applicable to utilities of varying size and maturity.

How utilities can ensure grid readiness: A holistic framework from NEOS Advisory

Smaller utilities may compress phases; large integrated utilities operating across multiple jurisdictions may need to run phases in parallel across business units.

Two implementation risks deserve specific attention. First, Phase 2 – building the integrated planning model – is the phase most likely to stall. It almost always encounters resistance from departments that are protective of their own models, assumptions, and data. Senior executive sponsorship and a dedicated cross-functional program team are prerequisites for success.

Second, Phase 6 (digital implementation) should not wait for Phases 3-5 to complete. Data quality improvement and critical digital infrastructure (GIS cleansing, AMI deployment, SCADA modernization) should begin in parallel with the planning work, because the planning outputs will be limited by the quality of the available data.

Implications for Leaders

An overview of the implications for utility leaders, regulators, and customers:

For Utility Executives
Grid readiness is a strategic capability, not an engineering backlog. Utilities that lead in this capability will secure competitive advantages in connection speed, regulatory credibility, investor confidence, and customer satisfaction. Those that lag will face growing interconnection queues, higher emergency capex, regulatory scrutiny, and deteriorating public trust. The investment required to build this capability is real but manageable; the cost of not building it – measured in stranded renewable investment, delayed electrification, and climate risk – is far higher.

The most important leadership action is to break down organizational silos: shared data, shared models, and shared accountability across the planning, operations, digital, finance, regulatory, and customer organizations. This is harder than any technology procurement decision, and more consequential.

For Regulators and Policymakers
Planning rules, tariff structures, and investment approval processes must evolve alongside utilities’ planning capabilities. If utilities are only permitted to invest after constraints become visible, customers will experience slow connections, higher outage risks, and more expensive emergency solutions. If investment processes require case-by-case justification without recognition of portfolio benefits, utilities will underinvest in resilience and overinvest in reactive reinforcement.

Regulators that move toward outcome-based frameworks – rewarding connection speed, reliability, renewable integration, and flexibility market development – create the conditions for utilities to adopt integrated readiness planning. Those that retain input-based, asset-by-asset approval processes will continue to receive fragmented, reactive investment proposals.

For Customers and Developers
Modern planning should produce tangible benefits for everyone seeking to connect to, or benefit from, the grid. Clearer hosting capacity signals enable developers to locate projects at less constrained points, reducing both private and social connection costs. Faster interconnection processes reduce financing costs and project attrition. Flexible connection agreements – where large customers accept curtailment in exchange for faster and cheaper connection – unlock capacity without reinforcement. Demand response and VPP programs create new revenue streams for customers with controllable loads.

The grid should not be a black box that produces connection refusals and delay letters. It should be a transparent, data-rich platform that enables economic development, decarbonization, customer choice, and resilience. Achieving this requires the integrated planning capability described in this article – and the will to build it.

Conclusion

The electricity sector is at an inflection point that will determine whether the infrastructure underpinning the energy transition is ready or whether the grid becomes the bottleneck that slows it. The answer depends not on whether utilities can build more – though more will need to be built – but on whether utilities can plan smarter: anticipating constraints before they become crises, using digital tools to extract more value from existing assets, deploying flexibility to defer and reduce capital requirements, and allocating capital with the discipline that a complex, uncertain, and high-stakes environment demands.

Resource adequacy planning, hosting capacity analysis, network master planning, digitalization, and investment planning are not five separate technical exercises conducted by five separate teams. They are five expressions of one integrated capability: utility readiness.

A utility that builds this capability – that integrates these disciplines into a common planning model, a shared scenario set, and a unified investment portfolio – is a utility that can connect new demand faster, integrate renewables at scale, withstand climate extremes, justify investment credibly, and deliver reliable and affordable service across the full energy transition.

The gap between planning-led utilities and reactive utilities is already visible in connection queue lengths, renewable integration rates, reliability statistics, and regulatory outcomes. It will widen further as the pace of change accelerates.

The future utility will be a planning-led, digitally enabled, and resilience-oriented platform. The utilities that will define the infrastructure of the next economy are not those that wait for constraints to become crises – they are those that treat planning as the most important strategic capability they possess.
